Actualizarea resurselor in TILOS se face afisand mai intai tabul aferent resurselor actuale. Selactam Tools-Options…
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-6.png?resize=503%2C170&ssl=1)

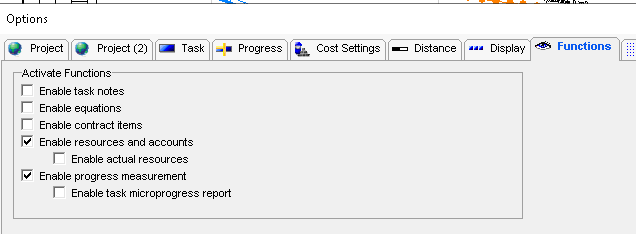

Selectam apoi optiunea Functions-> Enable actual resources
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-7.png?resize=636%2C234&ssl=1)
Putem acum vedea Tab-ul Actual resources in TILOS in fereastra de proprietati a activitatii- Tabul actualizarea resurselor:
Pentru a actualiza resursele, selactam tabul Actual Ressources, insa ar fi logic sa vedem resursele planificate initial.
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-9.png?resize=790%2C66&ssl=1)
Pentru a face legatura intre resursele planificate initial si resursele actuale, in dreptul fiecarei resurse definite in Library in Lista de resurse se va bifa optiunea Collect actuals
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-10.png?resize=790%2C295&ssl=1)
Dupa selectarea optiunii Collect actuals pentru resursele proiectului nostru, putem acum selectiona butonul Wizard „Add Actual ressources for planned Resources”
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-11.png?resize=790%2C112&ssl=1)

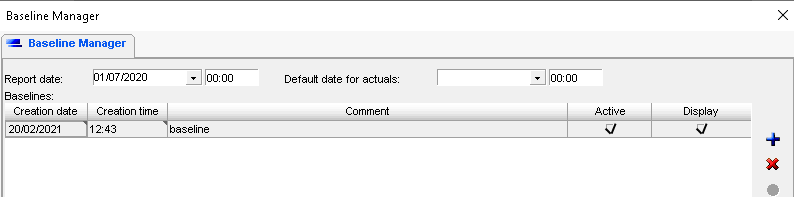

Inainte de a face actualizarile, ne asiguram ca avem baseline-ul de proiect salvat.
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-14.png?resize=790%2C196&ssl=1)

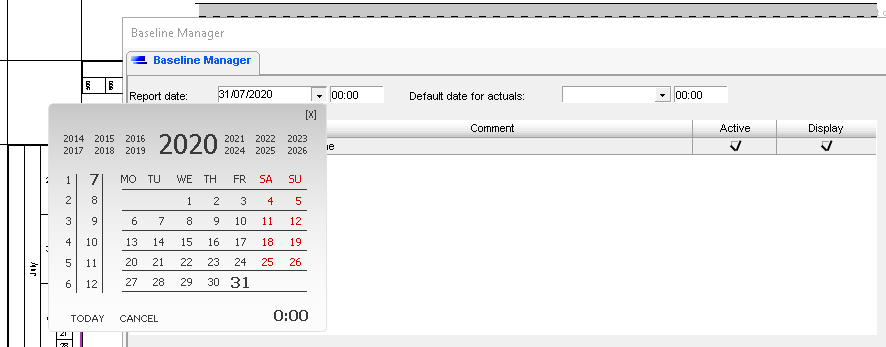

Dupa ce avem baseline-ul salvat, mutam data de raportare a proiectului.
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-15.png?resize=790%2C309&ssl=1)

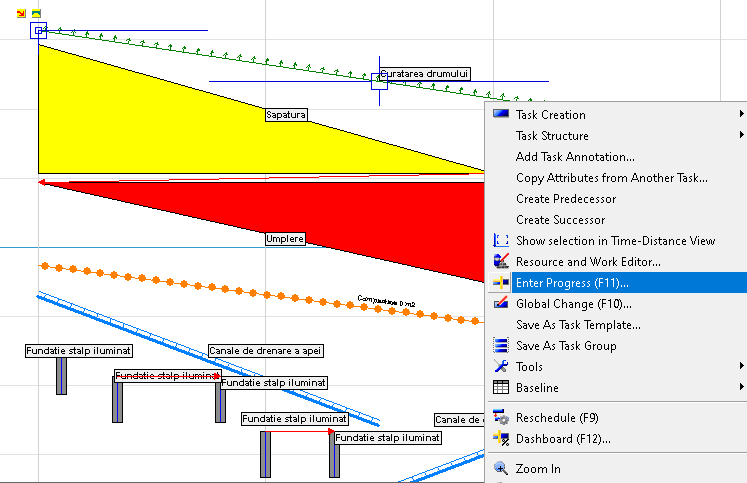

Selectam activitatea pe care vrem sa o actualizam si facem click dreapta Enter Progress (F11)
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-16.png?resize=747%2C483&ssl=1)
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-17.png?resize=515%2C363&ssl=1)
Adaugam progresul activitatii, presupunem ca activitatea este intarziata, deci spunem ca avem progres de la cota 1+000 pana la 3+000, schimbam end date in 31/07, insemnand progres pana in ziua raportarii. Apoi facem calcul de proiect f9 (optiunea reschedule non completed work)
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-18.png?resize=790%2C293&ssl=1)
Selectam acum activitatea actualizata( portiunea inainte de data de raportare) si adaugam informatiile resurselor actuale. Dupa selectarea butonului tip Wizard, selectam data la care vrem sa facem actualizarea resurselor.
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-19.png?resize=375%2C177&ssl=1)
Adaugam apoi valuarea actuala a unitatilor „Operation Value”, in baza careia se calculeaza costul actual
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-20.png?resize=790%2C71&ssl=1)
Putem vedea acum costurile actuale in Histograma de resurse si costuri

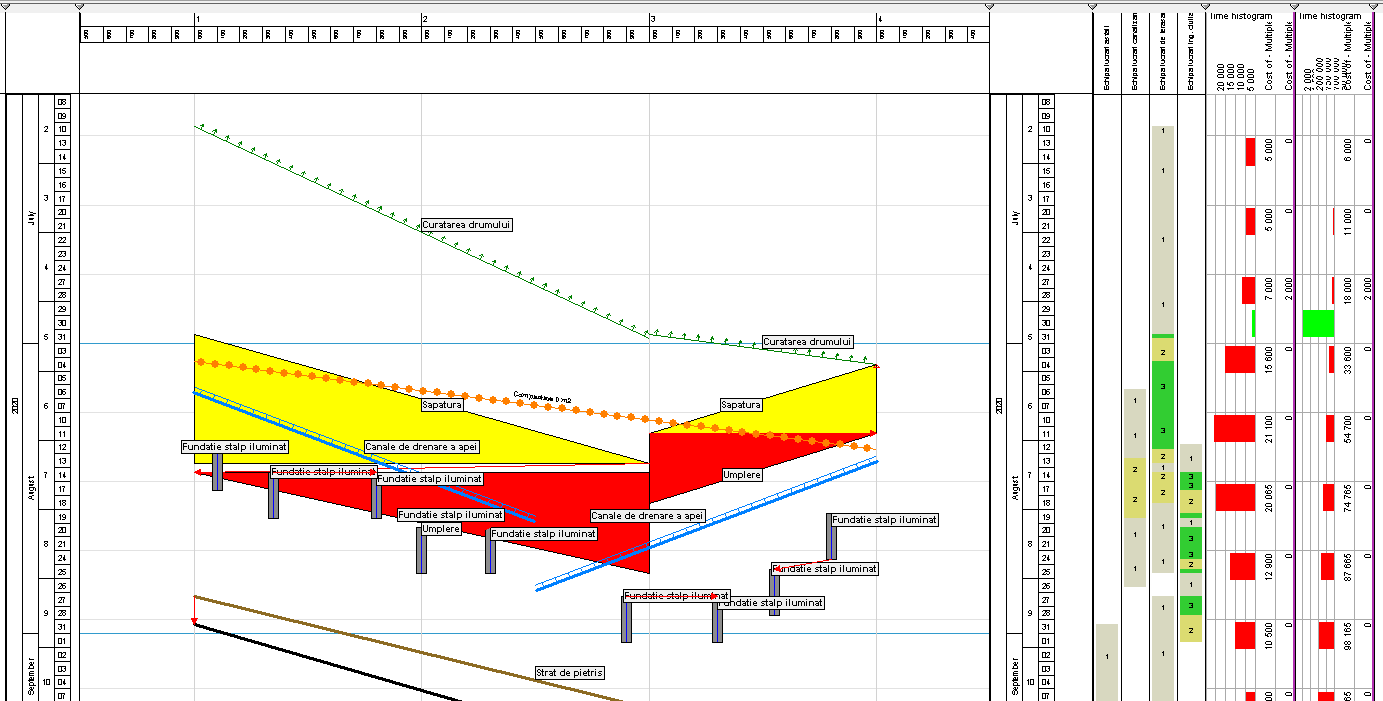

![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-21.png?resize=790%2C400&ssl=1)
Daca doriti sa afisati mai vizibil activitatea actualizata, puteti schimba modul de afisare al activitatii actualizate, Tools-> Options-> Display-> Progress Line

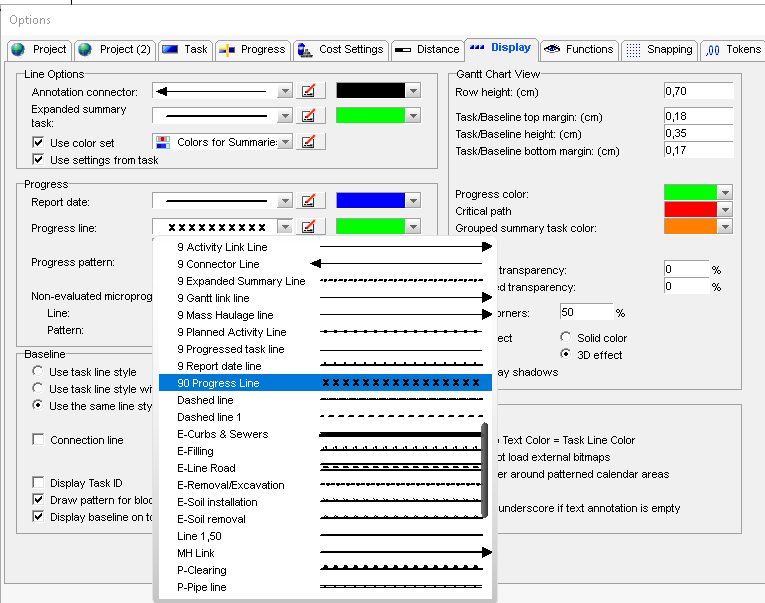

![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-23.png?resize=765%2C603&ssl=1)
Pentru afisarea liniei de progres bifam si display progress line in fereastra de proprietati
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-24.png?resize=790%2C118&ssl=1)
Rezultatul acestor setari:
![](https://i0.wp.com/ecostarplan.com/wp-content/uploads/2021/02/image-25.png?resize=790%2C383&ssl=1)
Daca doriti sa invatati mai multe despre planificarea si controlul proiectelor folosind TILOS, puteti participa la cursul nostru: Curs TILOS: Planificarea si controlul proiectelor liniare folosind TILOS – Ecostar Plan
